Balancing Trade Workloads So the Takt Train Does Not Break

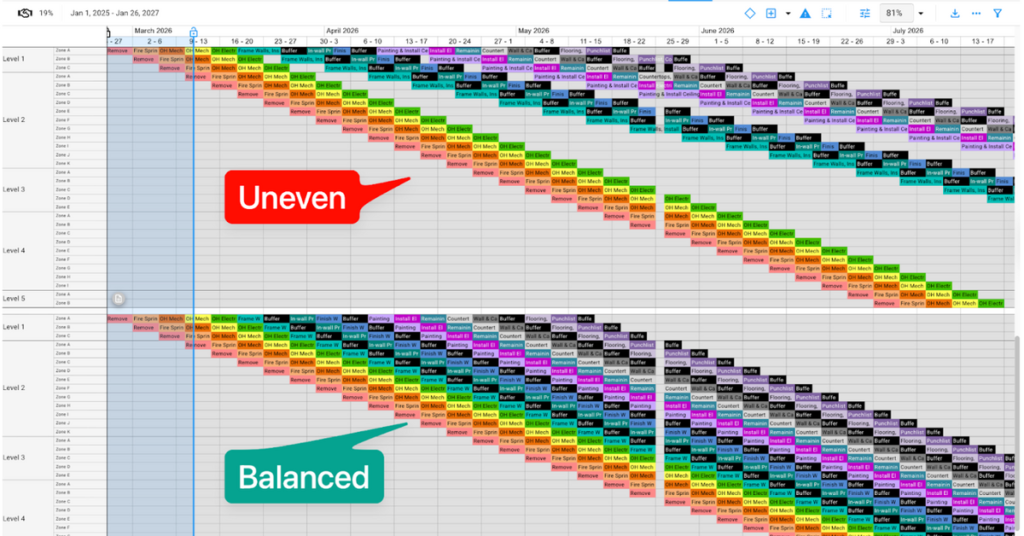

Balancing is not about making every trade happy. It is about creating a stable rhythm that the project can maintain. Stability is what prevents firefighting. If the same trade is always behind, the system is telling you something. Either the work is uneven, the zone is not truly repeatable, or the plan is not matched to actual crew capacity.

Start with quantities by zone. You do not need perfection, but you do need honesty. Break the scope into repeatable chunks, then compare time required per trade per zone. When you discover one zone has twice the effort, that zone is not a repeat, it is a risk. Name it, then decide whether to split it, resize it, or treat it differently with a planned buffer.

Next, look at crew shape. Some trades do not scale linearly with manpower, and some scopes have setup time that dominates. Balancing sometimes means changing the sequence, not just adding people. It can mean a two pass approach, rough then finish, so the train keeps moving while detailed work follows in a controlled way.

Also consider trade interference. A plan can be balanced on paper and still fail in the field if two trades need the same space at the same time. Balancing is not only time, it is space. This is why zoning and sequencing must be developed together, not in isolation.

A practical balancing workshop includes foremen. Ask them, in plain terms, where they anticipate losing time. Capture their concerns as production facts, not opinions. When foremen see that the plan reflects reality, they are far more likely to follow it, defend it, and improve it.

As the project runs, use simple metrics to keep balance honest. Did the trade finish the zone inside the beat. Was the handoff clean. What was the reason for variance. Using inTakt to track these patterns makes it easier to spot chronic imbalance early, before it becomes a schedule crisis.

Balancing is not a one time activity. It is a continuous system improvement loop. Each week you learn where the plan and reality disagree, and you adjust the system so flow gets stronger over time.
